主體結構檢測驗收的程序和要求:

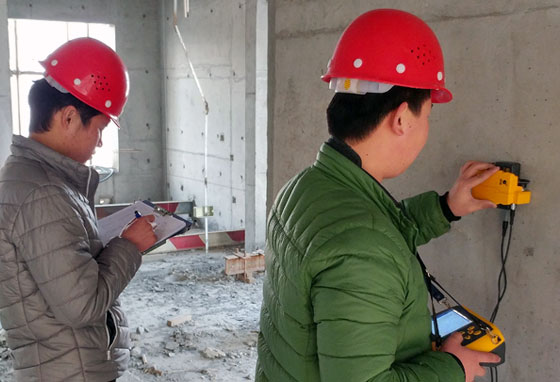

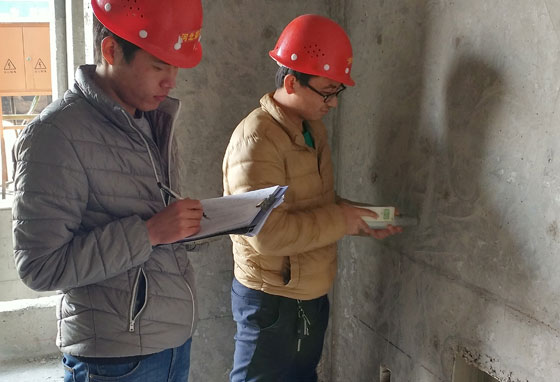

1、主(zhu)體分(fen)部(子分部)施(shi)工(gong)完成后,施(shi)工(gong)單位應(ying)組(zu)織(zhi)相(xiang)關人員檢查(cha),在自檢合格的(de)基礎(chu)上報監理機(ji)構總監理工(gong)程(cheng)師。主(zhu)體(ti)分(fen)部(bu)工(gong)(gong)程驗收前,施工(gong)(gong)單位應將分(fen)部(bu)工(gong)(gong)程質量(liang)控制資料,并簽(qian)注(zhu)結論(lun)和(he)意見整(zheng)理成(cheng)冊(ce)報送監(jian)理機構(gou)審查(cha),符合要求(qiu)后(hou)由(you)總監(jian)理工(gong)(gong)程師簽(qian)署審查(cha)意見,于驗收前三(san)個(ge)工(gong)(gong)作日通知質監(jian)站(zhan)。
2、總監理工程師(建設單位(wei)項(xiang)目負(fu)責人)收到上(shang)報的驗(yan)收報告,應及時組織參建四方(fang)對主體分部(bu)工(gong)程(cheng)進行(xing)驗(yan)收,驗(yan)收合(he)格(ge)后應填寫(xie)主體分部(bu)工(gong)程(cheng)質(zhi)量(liang)驗(yan)收記(ji)錄(lu),相關責任人簽(qian)字加蓋公章,并附分部(bu)工(gong)程(cheng)觀感質(zhi)量(liang)檢查記(ji)錄(lu)。對(dui)主體(ti)(ti)分部工(gong)程驗收(shou)時,必須有以下人(ren)員參加:總(zong)監理工(gong)程師、建設單位(wei)項(xiang)目(mu)負責(ze)(ze)人(ren)、設計單位(wei)項(xiang)目(mu)負責(ze)(ze)人(ren)、施工(gong)單位(wei)技術質量負責(ze)(ze)人(ren)及項(xiang)目(mu)經(jing)理。
3、條件主體分部驗收前,墻面上的施工孔洞須按規定鑲堵密實,并作隱蔽工程驗收記錄:未經驗收不得進行裝飾裝修工程的施工,對確需分階段進行主體結構檢測驗收時,建設單位項目負責人在質監交底上向質監人員提出書面申請,并經質監站同意。
4、混(hun)凝(ning)土(tu)結(jie)構工程模板應拆除并對其表面清理干凈,混(hun)凝(ning)土(tu)結(jie)構存在缺陷處應整改(gai)完成;樓(lou)層標(biao)高控制線應清楚彈出墨線,并做醒目標(biao)志;工(gong)程(cheng)技術資料存(cun)在(zai)的問題(ti)均已悉數整改完(wan)成;施工(gong)合同和(he)設(she)計文件(jian)規定的主(zhu)體分部工(gong)程(cheng)施工(gong)的內容已完成,檢驗(yan)(yan)、檢測報告(gao)應符合現行驗(yan)(yan)收規范和(he)標(biao)準的要求(qiu)。
5、安裝(zhuang)工程中各類管道預埋結(jie)束,位置尺寸準確,相應(ying)測試(shi)工作已完(wan)成(cheng),其結(jie)果(guo)符合規定(ding)要求;主體結構檢測驗收前,可完成樣板間或樣板單元的室內粉刷;主體分部工(gong)程施工(gong)中,質監站發出整(zheng)改(停工)通知(zhi)書(shu)要(yao)求(qiu)整(zheng)改的質量問題都已整(zheng)改完成,完成報告書(shu)已送質監站(zhan)歸檔(dang)。
